Recap:
- Steel reinforcement for concrete floor between Block 5 (Kitchen/Cafeteria), 100%.

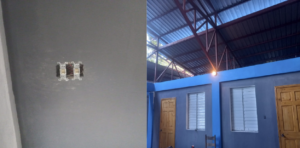

- Electrical work Block 5 hallway 3 & 4, 50%.

- Pouring concrete parquet flooring, Block 5 (Kitchen/Cafeteria), 60%.

- Application of paint on walls, 50%

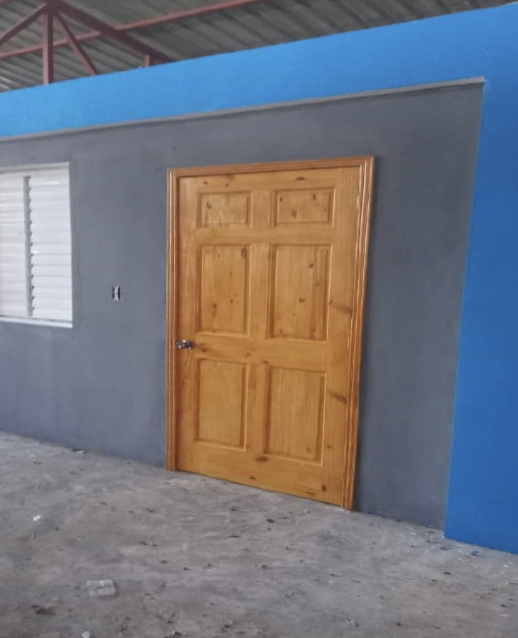

- Classroom doors installation, 100%

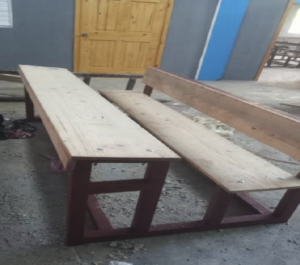

- Manufacturing student benches/desks, 45%

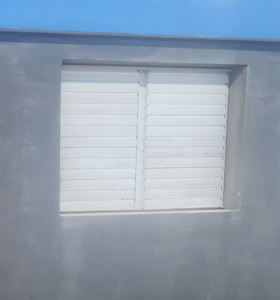

- Windows installation

Our operations are currently at the following stages: Wall finishing; Building roofing;  Door and window installation; Electrical installation; Plumbing and fixtures; Painting; and Furnishing.
