WEEK 52 (June 12-19)
Below is a summary of activities completed during the previous period.
a) Aluzinc sheet metalinstallation, block 1(Administration): This activity is completed at 5 % during this week.
b) laying laths (metalroofing), block 1 (Administration): This activity is completed at 100 % during this week.
c) laying laths (metalroofing) , block 2 (Library/ Computer) : This activity is completed at 100 % during this week.
d) laying laths (metalroofing), block 3 (Clasrooms 1-3): This activity is completed at 100 % during this week.
e) Welding metal roofs, block 1 (Administration) : This activity is completed at 100% during this week.
f) Welding metal roofs, block 3 (Classrooms 1); his activity is completed at 100% during this week.
g) Steel reinforcementfor top chain beam, block 4(Classrooms 4-6) : This activity is completed at 100% during this week.
h) Formwork for top chainbeam, Block 4 (Classrooms 4-6): This activity is completed at 100% during this week
i) Pouring concrete for top chain beam, Block 4 (Classrooms 4-6): This activity is completed at 100% during this week

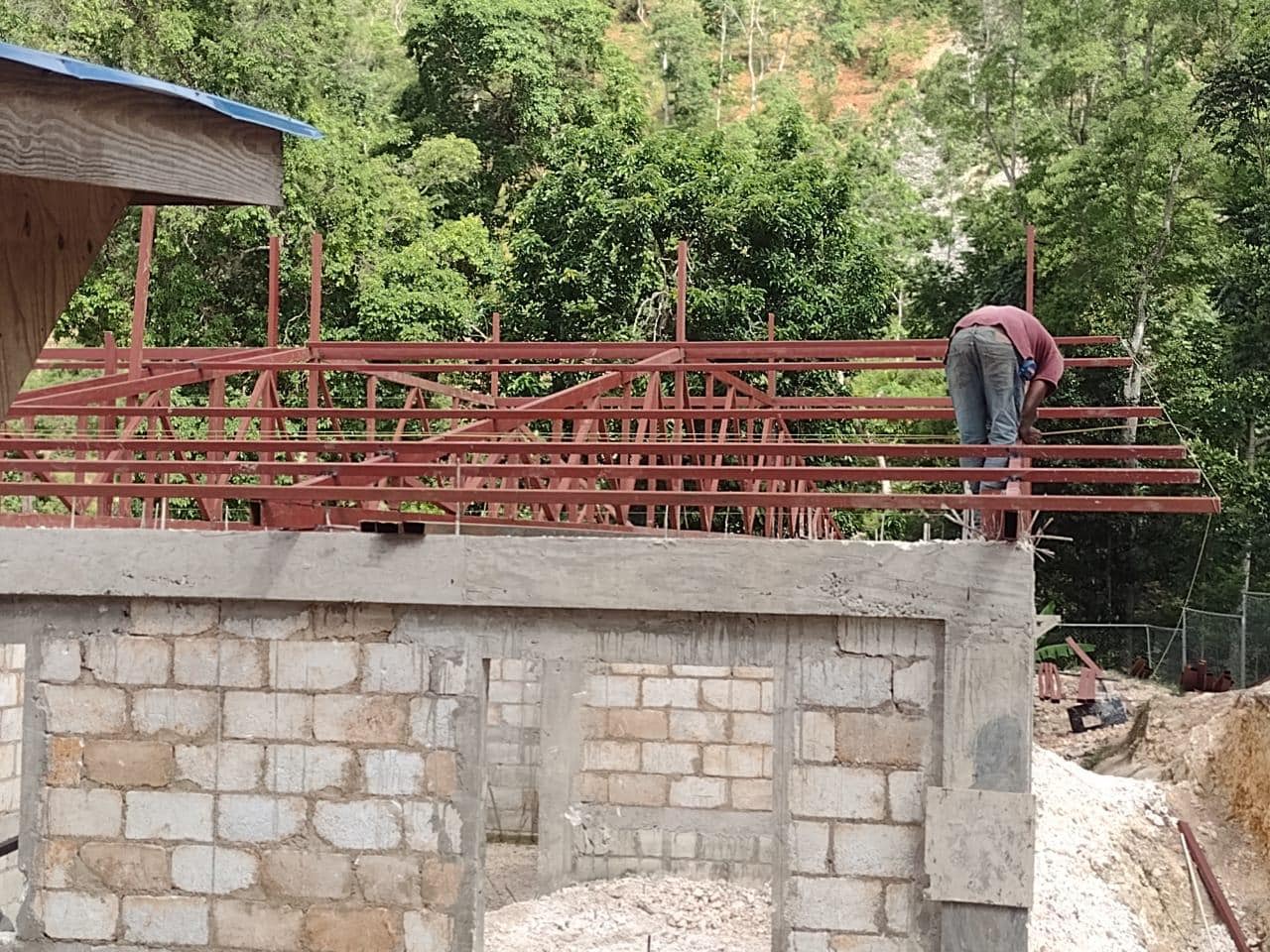

j) Steel structure for roofing, Block 4 (Classrooms 4-6), (25%): This activity is completed at 25 % during this week.
