Week 40 (March 22-27, 2024)
Construction of Jolley School, School

Week 40 (March 22-27, 2024)

Recap:
We are at STEP 4 (Step 4 Vertical Wall Erection: Concrete Block and Masonry) of the Calendar of Activities agreed upon on May 18, 2023.
Below is a summary of activities completed during the previous period.

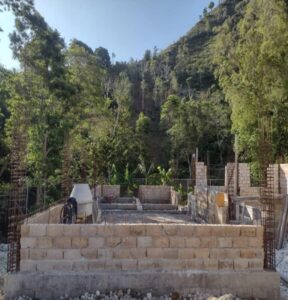

1. Laying cement blocks, Block 4 (Classrooms 4-6), 100% complete

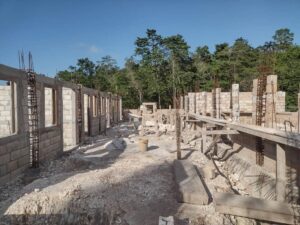

2. Steel columns installation, Block 5 (Kitchen/Cafeteria), 50% complete.
This week, we began installing the steel columns in building 5.
-Laying cement blocks on floor beams, Block 5, 0% complete

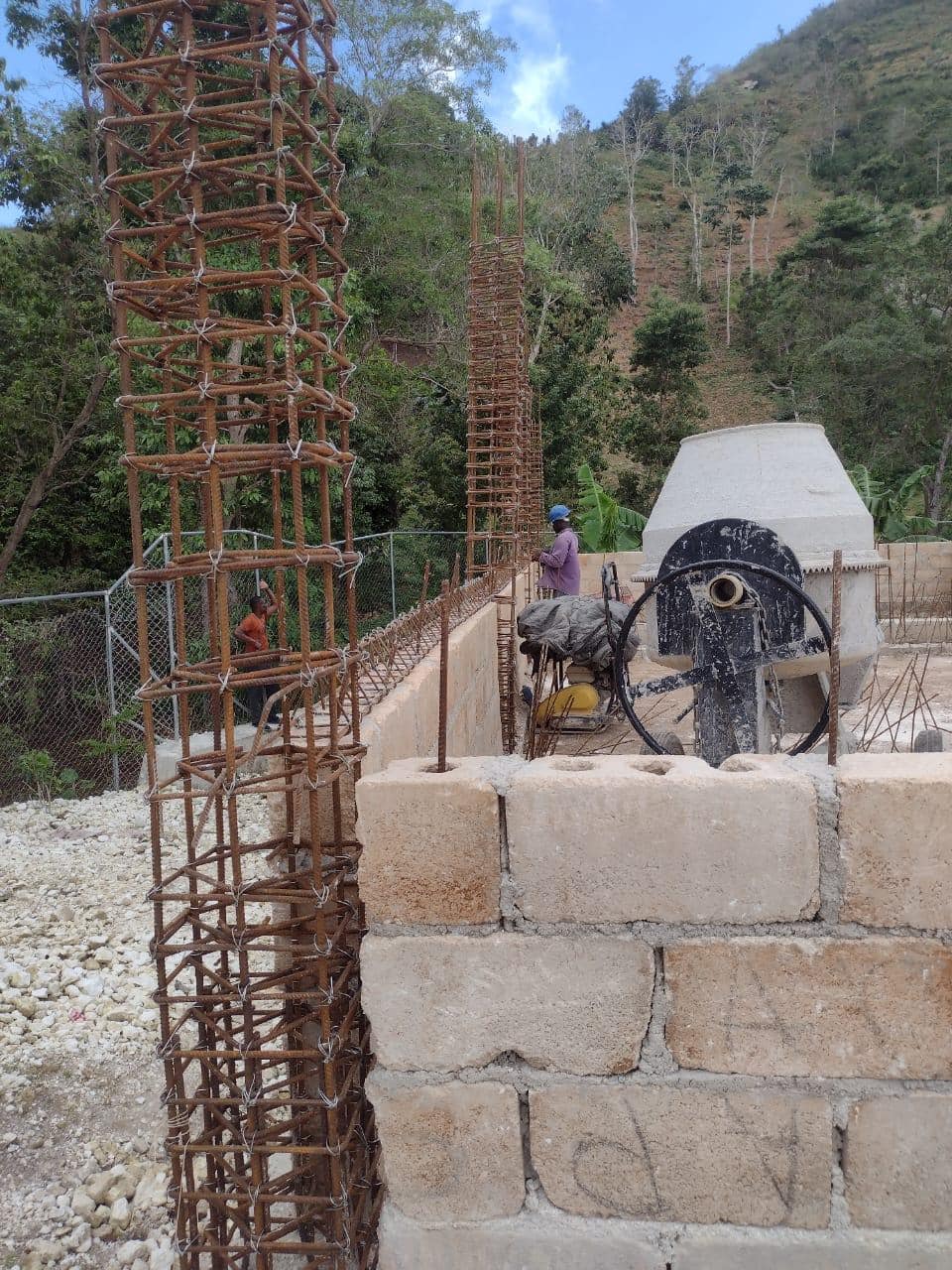

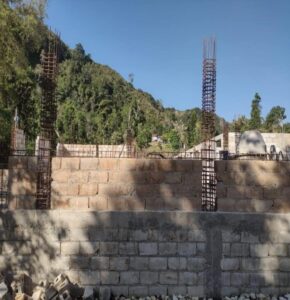

-Steel reinforcement for intermediate chain beam, Block 5, 50% complete
-Formwork for intermediate chain beam, Block 5, 0% complete
-Concrete pouring for intermediate chain beam, Block 5, 0% complete

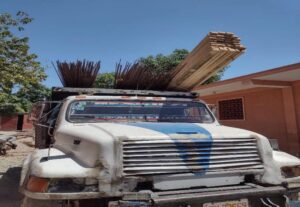

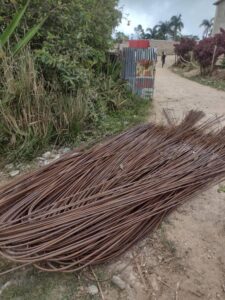

-Transportation of steel rebar from Leogane to Tavet’s depot, 8,000 lbs, 100% complete

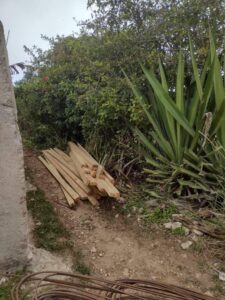

-Transport of 15 sheets of plywood, 35 wood planks 2*4*16, 2 boxes of nails, 5 saw blades, 5 boxes of concrete nails 3 ‘, 4 wire ties (rebar stirrups) from Leogane to Tavet, 100% complete

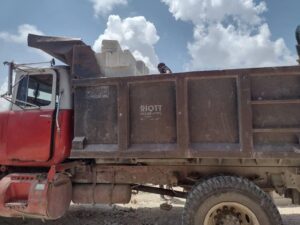

-Transport of 1000 cement blocks size 15 from Petit-Goave to Tavet, 100% complete
-Overall percentage of work completed :
38.50%
Previous period: 37.00%

+1 (801) 830-3043

mail@haitihealthinitiative.org

Haiti Health Initiative aims to improve the overall health and well being of rural Haitians, one community at a time. We seek to accomplish this through providing education and services in primary health care, dental care, public health, and nutrition within each community at risk.

If you have questions about Haiti Health Initiative, contact

Marc-Aurel Martial at

mmartial@haitihealthinitiative.org

or at 801-830-3043.

© All Copyrights 2024 by Haiti Health Initiative
